Given the nature of infrastructure repair and the Saskatchewan climate, please note that these schedules are subject to change. The 2026 work is scheduled for 1st Avenue East only. Residents and visitors can expect some adjustments to traffic flow. For planned detour routes, visit the Traffic Plans page. 1st Avenue East residents and businesses should expect minimal disruption to water service. 1st Avenue businesses will remain accessible.

Bullin Construction Water Main Replacement Full Project Schedule (as of March 2026)

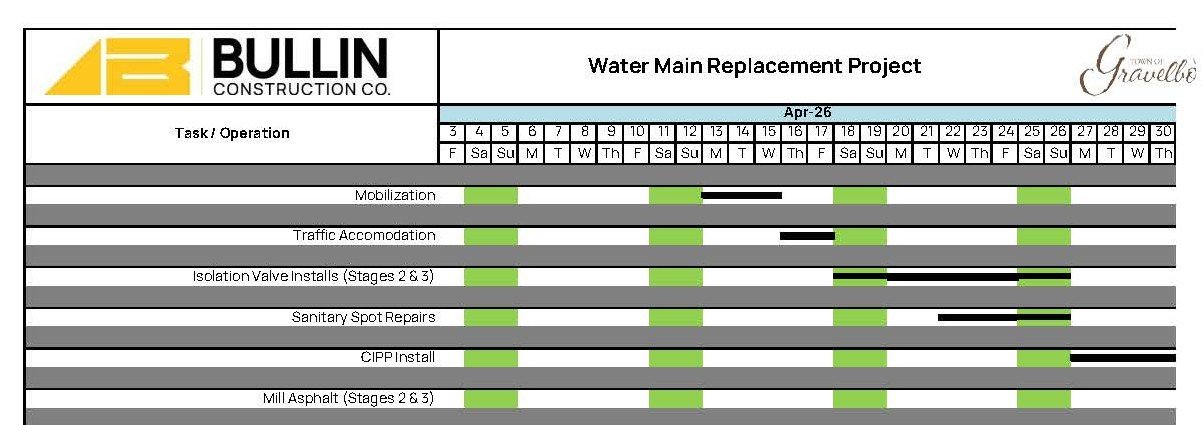

April 2026

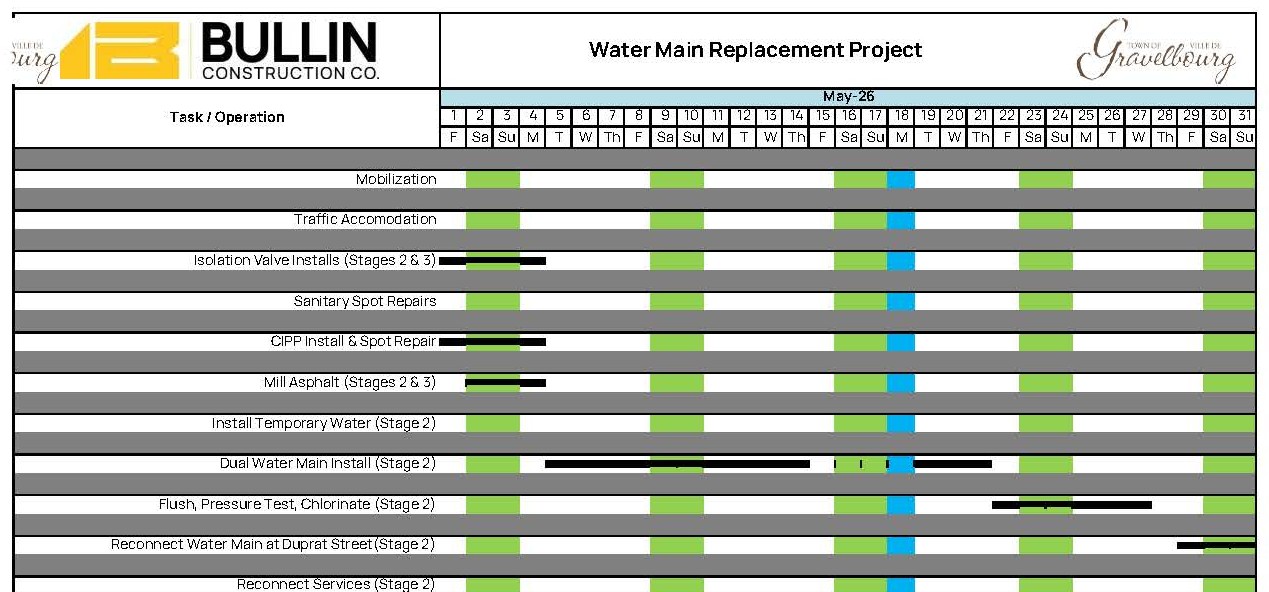

May

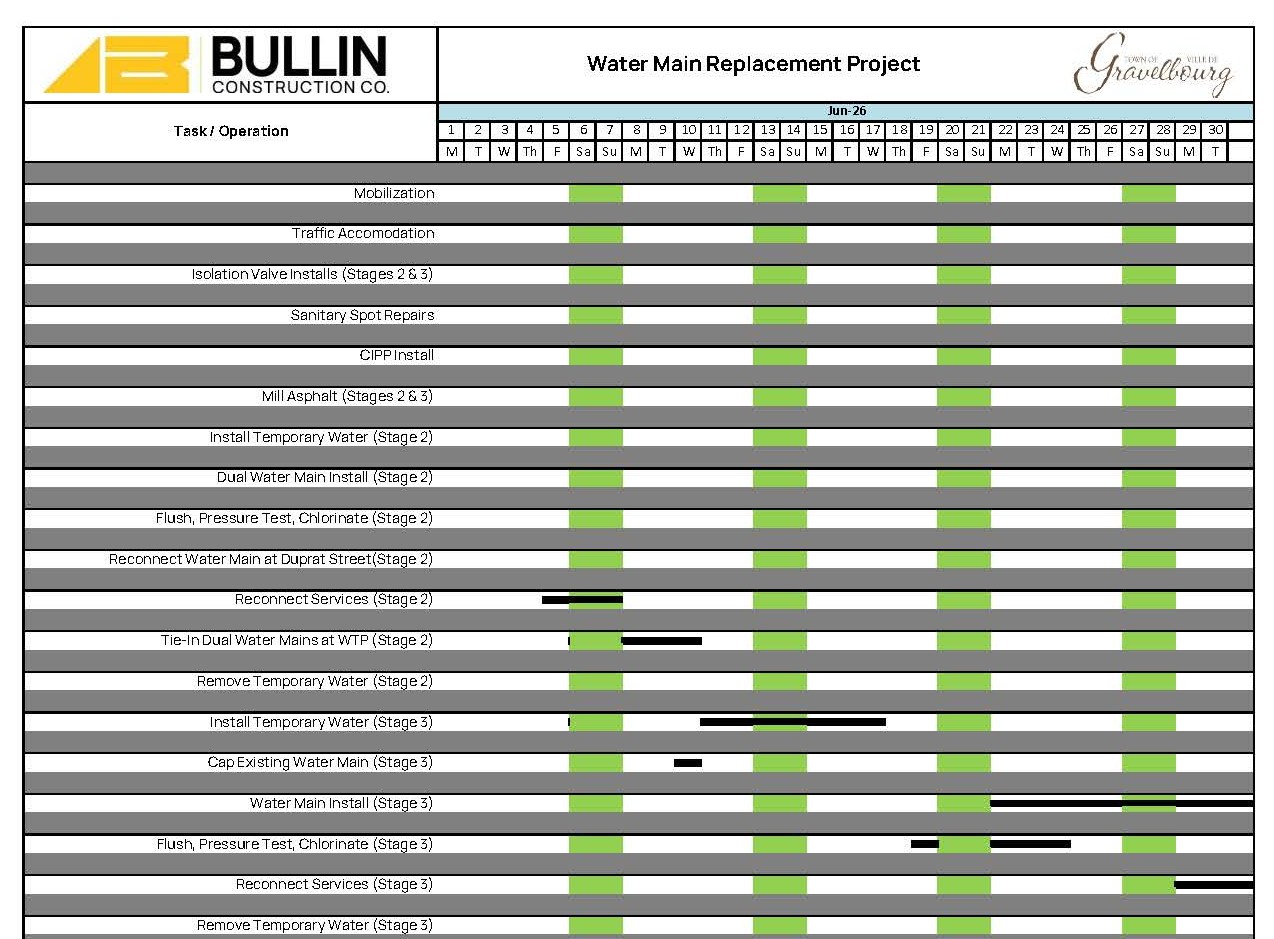

June

July
